Project Brief

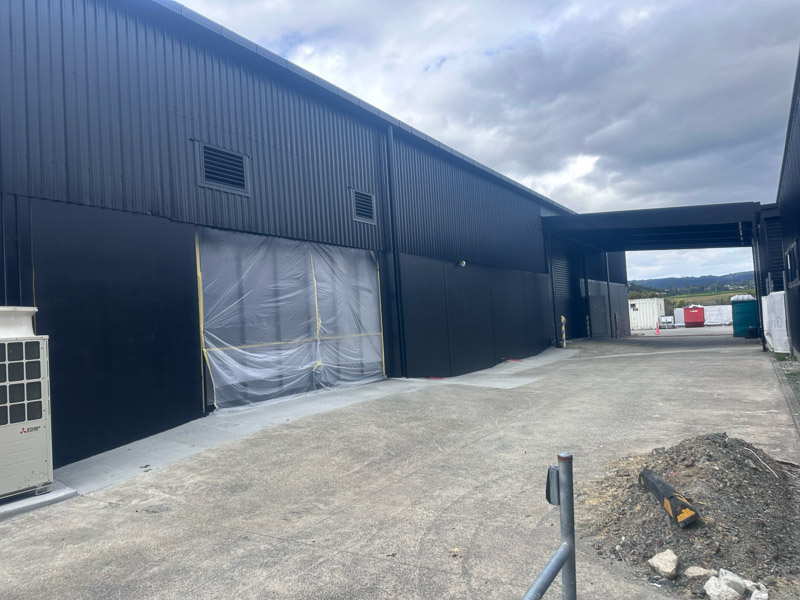

Exterior Building Painting
Project Overview
This project involved painting the exterior of a commercial building that had been delayed due to rainy winter weather. We officially began the painting work at the end of August, during the transition from winter to spring. The primary goal was to refresh and protect the building’s exterior, ensuring a durable and aesthetically pleasing finish that could withstand the elements, while addressing the challenges posed by the unpredictable weather and site conditions.

Challenges Overcome
Weather Delays:
The project had originally been scheduled to begin earlier, but persistent rainy weather over winter caused significant delays. This put the timeline behind and presented a challenge, as we had to reschedule resources and carefully plan our painting windows around intermittent dry spells.
Cold Temperatures and High Humidity:
As we began work in late August, early spring weather brought with it unpredictable conditions. Cold temperatures at night and high humidity levels during the day made painting a particularly challenging task. Paint can struggle to adhere properly or dry at the correct rate in these conditions, which means we needed to use specialized products and techniques to ensure quality results.
Ensuring Proper Paint Adhesion:
The combination of humidity and cool temperatures meant we had to be mindful of the paint’s curing process. We worked with suppliers to select high-performance coatings designed to resist the effects of high moisture and temperature fluctuations. These coatings were essential in ensuring the paint stuck properly and dried to a smooth, even finish.
EWP (Elevated Work Platform) Safety Compliance:
A critical element of the project was working at height, requiring the use of an Elevated Work Platform (EWP). Before starting, we ensured that all safety checks and maintenance were up to date, and our team underwent additional training to comply with the latest safety standards. This was a key step in maintaining a safe working environment for our staff, particularly when working in varying weather conditions.
Site Access and Logistics:
The building’s location presented some logistical challenges regarding access and equipment placement. We had to carefully plan the positioning of the EWP and other tools to minimize disruptions and ensure smooth, uninterrupted work. Coordination with other contractors on-site was necessary to prevent delays.
Level of Difficulty
Given the weather-related delays, temperature fluctuations, and the safety requirements associated with working at height, this project posed a moderate to high level of difficulty. Each challenge required close attention to detail and meticulous planning to ensure that the paint job would both look great and endure the harsh external conditions.
Key Takeaways
- Close monitoring of weather conditions and adjusting work schedules accordingly.
- Use of specialized products suited for high humidity and cool temperatures.
- Ensuring that all safety equipment, especially the EWP, was in optimal condition.
- Collaboration and careful planning to manage site access and resource allocation.
Despite these hurdles, we successfully completed the project on time, ensuring that the building’s exterior was fully protected, with a beautifully applied finish that will last for years to come. Our team’s ability to adapt to the challenges of the season and make smart adjustments along the way ensured the overall success of the project.
